Wanlihe

How to size a rainwater storage system

Sizing a rainwater storage system is four decisions taken in order. The duty comes first, because it decides the wrap and the wrap changes what the tank does. Then the volume, taken from the catchment and the design storm rather than from the hole available. Then the depth, which fixes how many modules stack. Then the load from whatever the surface above will carry. Take them out of order and the tank gets sized around the excavation instead of the job.

What decides the choice

The duty, before anything else
Attenuation holds water back and releases it. Harvesting keeps it. Infiltration lets it go into the ground. All three use the same modules, and the wrap is what separates them.
The volume the job actually needs
The target comes from the area draining to the tank and the storm the site is designed against. It is not the size of the excavation, and the excavation should not be allowed to set it.
The depth available
Depth is the lever on plan area. The excavation sets how many modules stack, and a tank one module deeper generally needs noticeably less ground.
The load the surface will put on it
Once buried, the ground above goes back to use. Guidance generally allows trafficked ground where the structural performance has been shown to be adequate, so the loading has to be stated.
Where the treatment happens
A geocellular system generally provides no water quality treatment of its own. If the site needs it, it has to be a stage ahead of the tank, sized and reachable.

What the wrap decides

DutyWrap and connectionsWhat happens to the water
AttenuationWaterproof wrap, flow control at the outletHeld back, then released at the permitted rate
HarvestingWaterproof wrap, pump position designed inKept and drawn off for reuse
InfiltrationGeotextile wrap, no outletReleased into the surrounding ground
  • Attenuation

    Wrap and connections
    Waterproof wrap, flow control at the outlet
    What happens to the water
    Held back, then released at the permitted rate
  • Harvesting

    Wrap and connections
    Waterproof wrap, pump position designed in
    What happens to the water
    Kept and drawn off for reuse
  • Infiltration

    Wrap and connections
    Geotextile wrap, no outlet
    What happens to the water
    Released into the surrounding ground

What a geocellular system is good at, and what it is not

AspectHow guidance rates itWhat that means on site
Peak flow reductionGoodThis is the job the tank is usually bought for
High flow eventsGenerally capableThe system can take the storm it was sized for
Volume reductionPoor when it only stores; good with infiltrationIf volume has to drop, infiltration has to come from somewhere
Water quality treatmentNone of its ownTreatment has to be a separate stage ahead of the tank
Monitoring and maintenanceGenerally difficult once buriedThe access built at installation decides the outcome
  • Peak flow reduction

    How guidance rates it
    Good
    What that means on site
    This is the job the tank is usually bought for
  • High flow events

    How guidance rates it
    Generally capable
    What that means on site
    The system can take the storm it was sized for
  • Volume reduction

    How guidance rates it
    Poor when it only stores; good with infiltration
    What that means on site
    If volume has to drop, infiltration has to come from somewhere
  • Water quality treatment

    How guidance rates it
    None of its own
    What that means on site
    Treatment has to be a separate stage ahead of the tank
  • Monitoring and maintenance

    How guidance rates it
    Generally difficult once buried
    What that means on site
    The access built at installation decides the outcome

Where it can be used

Site typeGenerally considered suitableWhat to check first
Residential, commercial, industrialYes, including high-density layoutsThe load the surface above will put on the modules
RetrofitYesWhether the modular form fits the space that is actually available
Contaminated or vulnerable groundwaterGenerally treated as suitableThe site assessment, since infiltration may be ruled out
  • Residential, commercial, industrial

    Generally considered suitable
    Yes, including high-density layouts
    What to check first
    The load the surface above will put on the modules
  • Retrofit

    Generally considered suitable
    Yes
    What to check first
    Whether the modular form fits the space that is actually available
  • Contaminated or vulnerable groundwater

    Generally considered suitable
    Generally treated as suitable
    What to check first
    The site assessment, since infiltration may be ruled out

How to work through it

  1. Settle the duty

    Decide whether the tank attenuates, harvests, or infiltrates. That sets the wrap, and the wrap is ordered with the modules rather than added on site.

  2. Get the permitted discharge rate

    For attenuation, ask for the rate the site is allowed to discharge at. Without it there is nothing to size the tank and the outlet against.

  3. Work out the volume, then the depth

    Take the volume from the catchment and the design storm. Then let the available depth decide the plan area, not the other way round.

  4. State the loading on the surface

    Say what will be above the tank: a car park, a fire access route, planting. The modules are specified against that loading, not against a default.

  5. Draw the access before you order

    Inspection wells, the pump position, and any pre-treatment device have to be on the layout. A buried tank cannot be opened up to add them later.

Mistakes to avoid

  • Sizing the tank from the hole

    It is tempting to size the tank by the excavation that is available. That gets the answer backwards, and the tank ends up matching the hole rather than the job.

  • Forgetting the outlet entirely

    Without a flow control an attenuation tank has no release rate, so there is nothing to size it against. The tank and the outlet come out of the same calculation.

  • Assuming the tank treats the water

    Grit and leaf litter settle in a tank that was never given anywhere to hold them. Clearing that out later means opening a buried structure that was not built to be opened.

  • Leaving the access to site

    Marking up an inspection well on the day means marking it up after the modules are already in the ground. By then the position is fixed, not chosen.

Sizing one of these is not difficult. It is easy to do in the wrong order, and that is where most of the trouble comes from.

The volume is not the excavation

It is natural to size a tank by the hole that is available, especially on a tight site. That gets the answer backwards. The volume comes from the catchment and the design storm. The excavation is then made to fit that volume.

A tank sized from the hole will be either too small to meet the condition it was bought for, or larger than it needed to be. Neither shows up until the site is built on.

The wrap is a design decision

The same block becomes an attenuation tank, a harvesting tank, or a soakaway depending on what it is wrapped in and how it is connected. That makes the wrap part of the specification, and it means the duty has to be settled before anything is ordered.

Cross-section of a buried modular tank: an inlet pipe drops from a paved surface into a wrapped tank of stacked modules, a flow control chamber sets the release rate to the downstream drain, and an inspection well reaches the tank.
The parts of the system that have to be decided together.

The parts that cannot be added later

Inlet and outlet levels, the pump position, the inspection well, and any pre-treatment stage all go into the layout on paper. Once the tank is covered and the surface is back in use, the only access is the access that was built.

This is the part of the design that decides whether the system still performs in ten years. It is also the part that is easiest to leave to site, which is why it is worth writing down.

Where to go next

Sources

General industry background on this page draws on the sources below. Product data comes from the manufacturer's product literature.

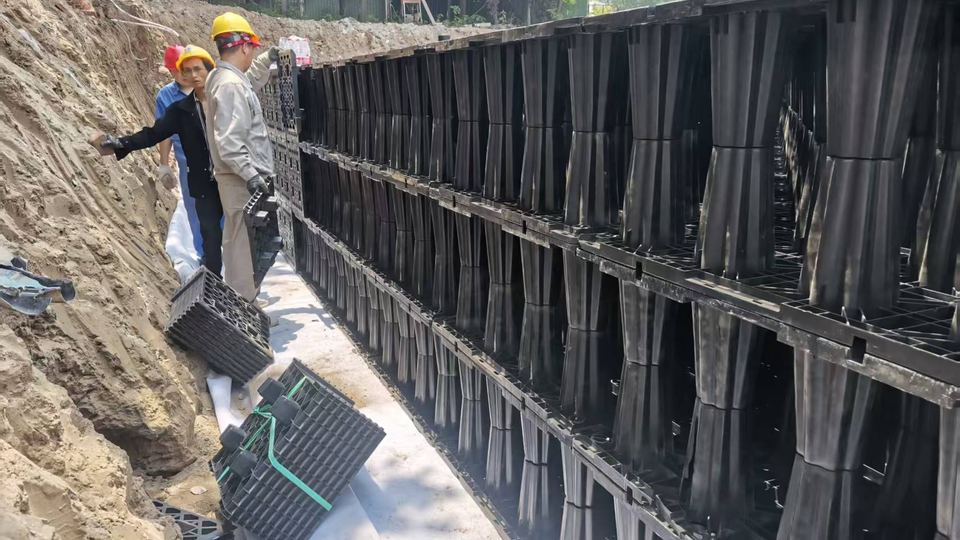

  • Tank assembled on site
